Early in Jesus’ ministry, crowds gathered to witness His power. In Luke 5, a paralyzed man’s friends faced a blocked path to Jesus. Undeterred, they lowered him through the roof, and Jesus forgave and healed him. The crowd responded with awe: “We have seen extraordinary things today” (Luke 5:26).
This story challenges us. Could we, like the crowd, unintentionally block the way for others? Not out of malice, but by overlooking the needs of the marginalized or differently abled.
This is why we’re launching the Widening Our Welcome campaign. We aim to make our church a place where everyone can experience Jesus' love. Through this effort, we will:
This campaign is about faith in action—creating spaces where all can “come in” to experience Christ’s presence. Join us in this transformative journey. With your prayers and generosity, we’ll see “extraordinary things.”

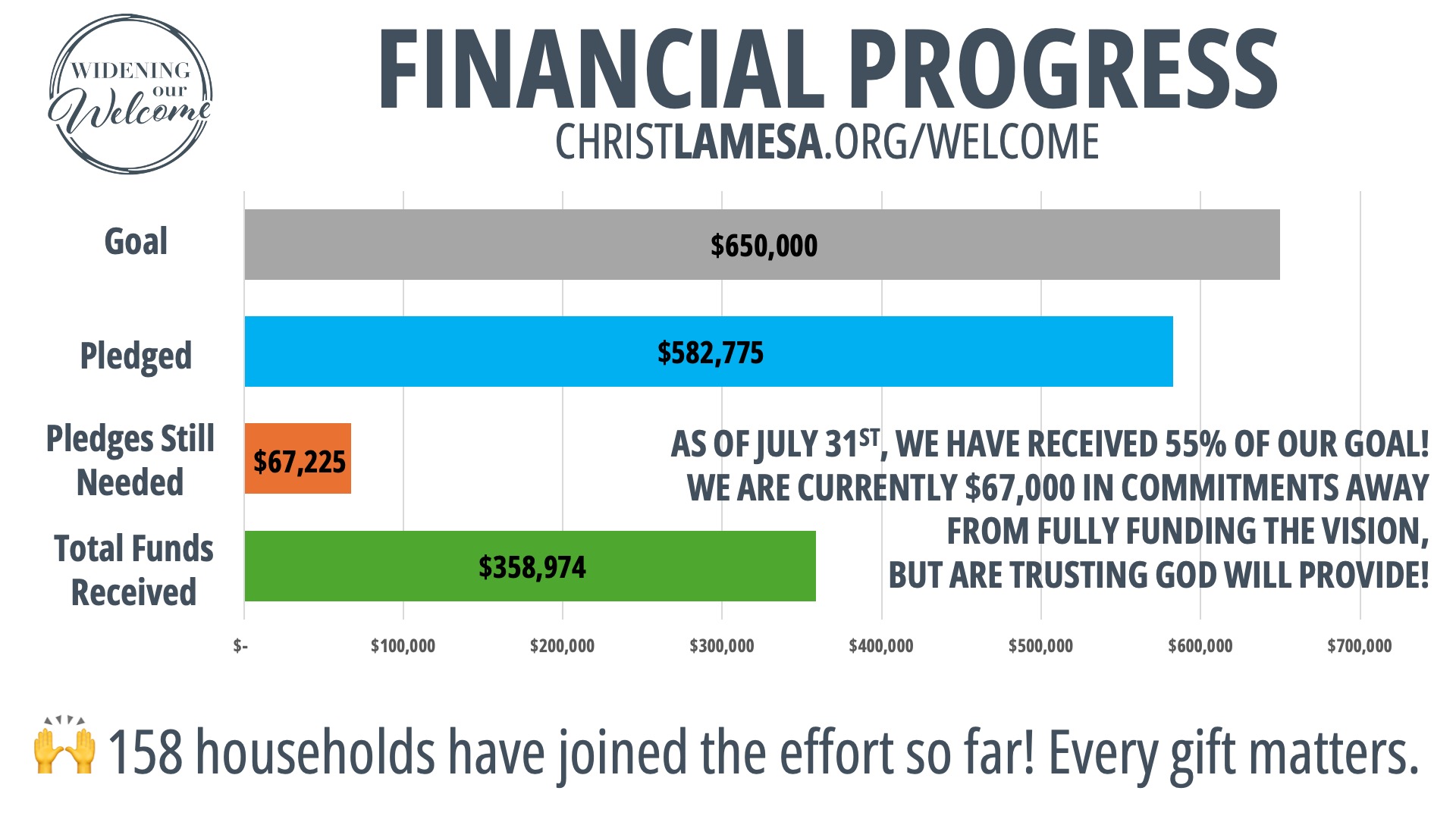

If, as an act of faith and generosity, families and individuals make a commitment above and beyond their current tithe/offering, we can raise all necessary funds in one year.

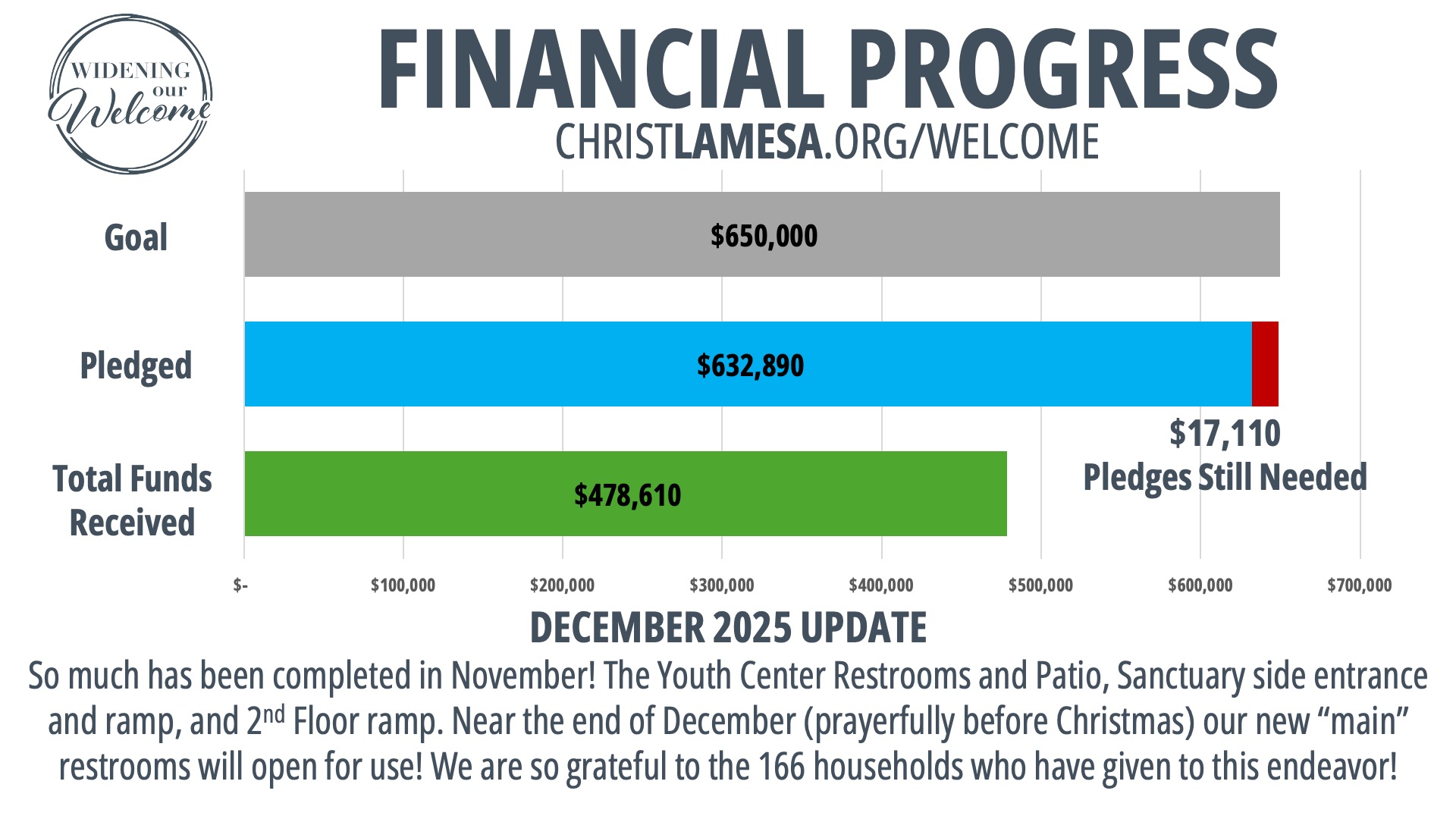

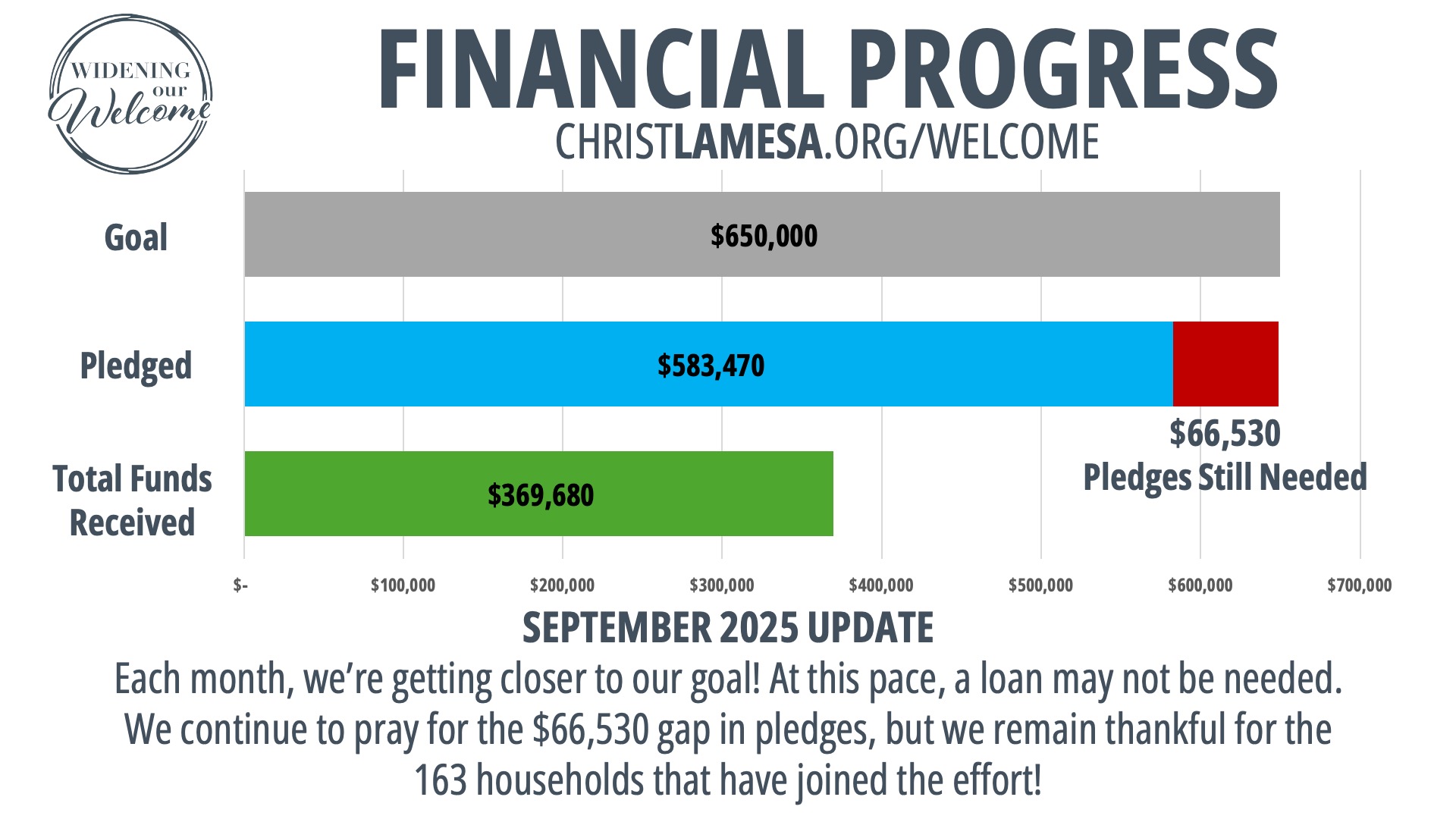

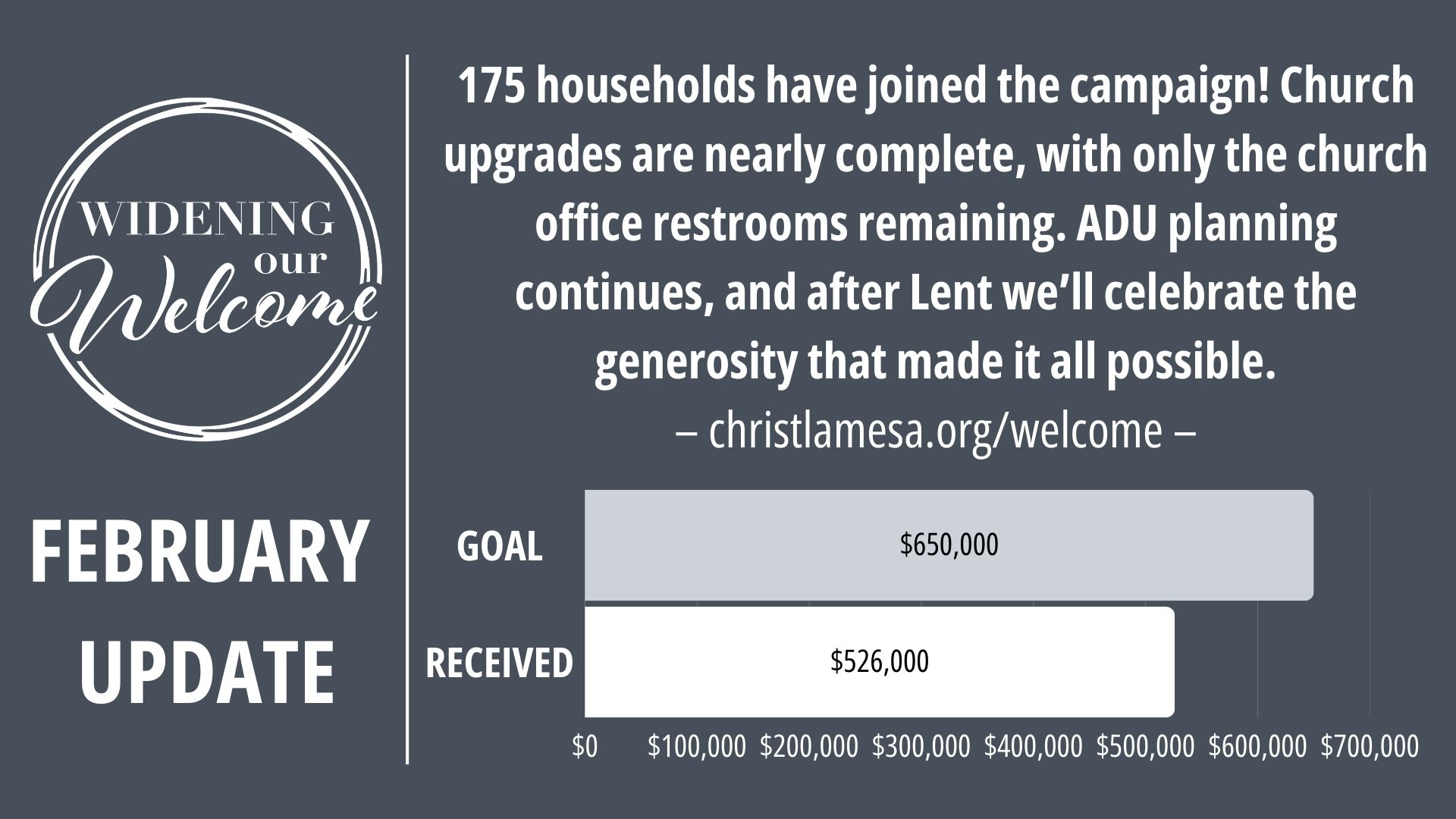

Here is the progress we’ve made, current as of December 1, 2025:

Timelines are subject to change based on numerous factors.
January 2025
Architects begin working with the City of La Mesa to obtain permits.
March 23, 2025
Special Voter’s Meeting held. Approved to accelerate the project through the use of a loan or line of credit if necessary.
May 27-28, 2025
Permits approved by the City of La Mesa. Invitations to bid were sent to contractors.
June 24, 2025
Molinar Construction, a La Mesa-owned and operated company, was awarded the contract for all work.
July 2025

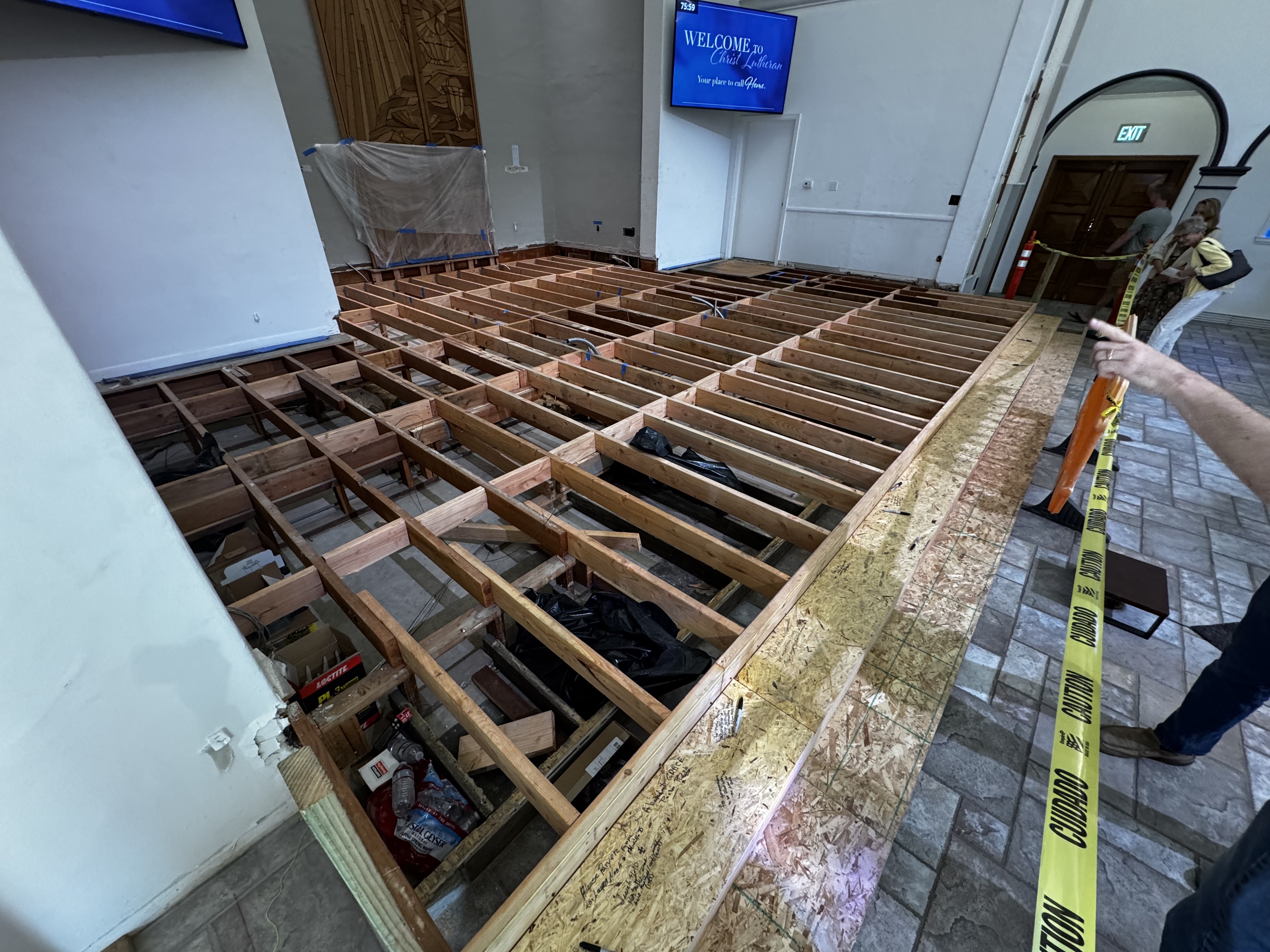

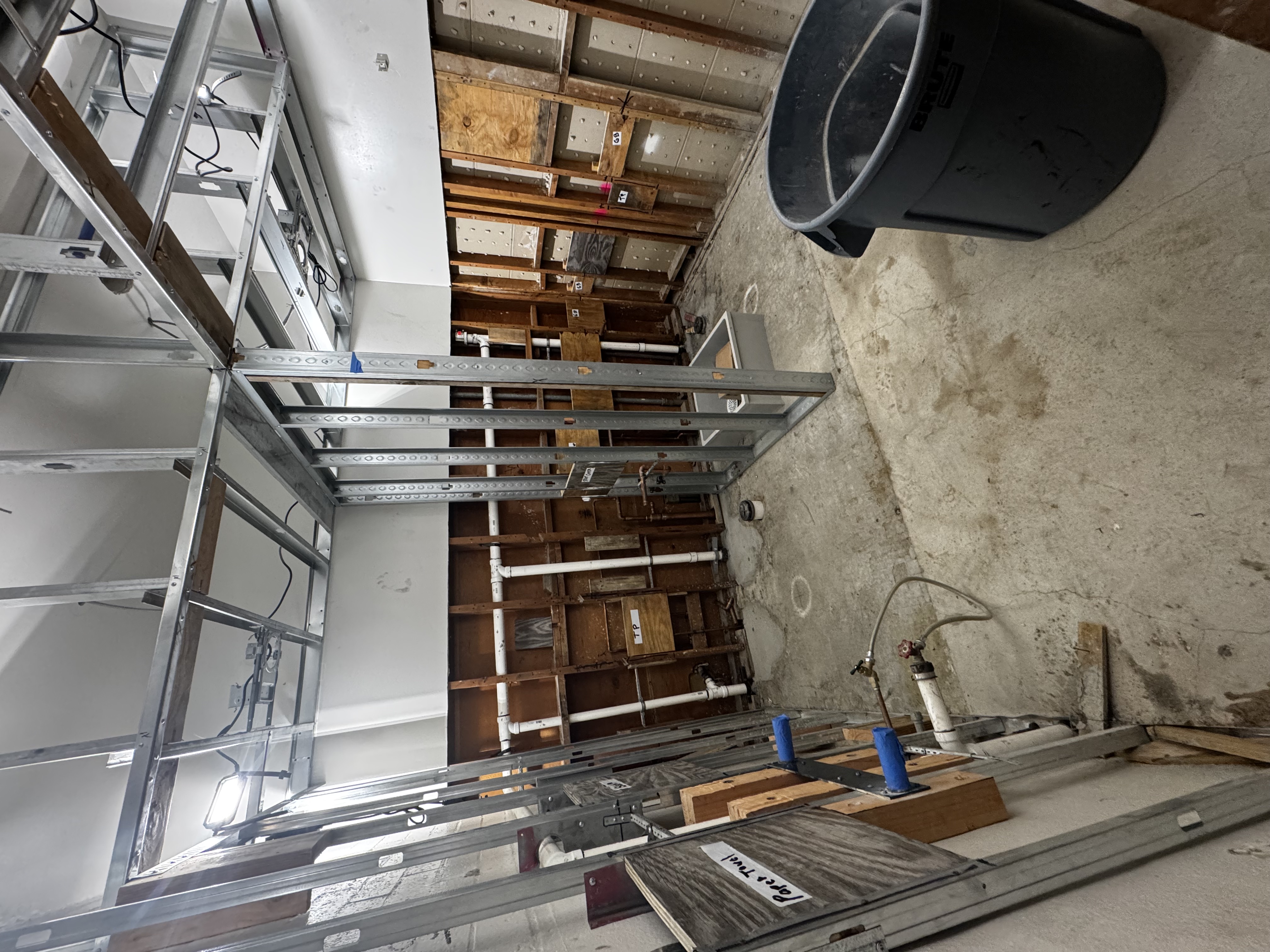

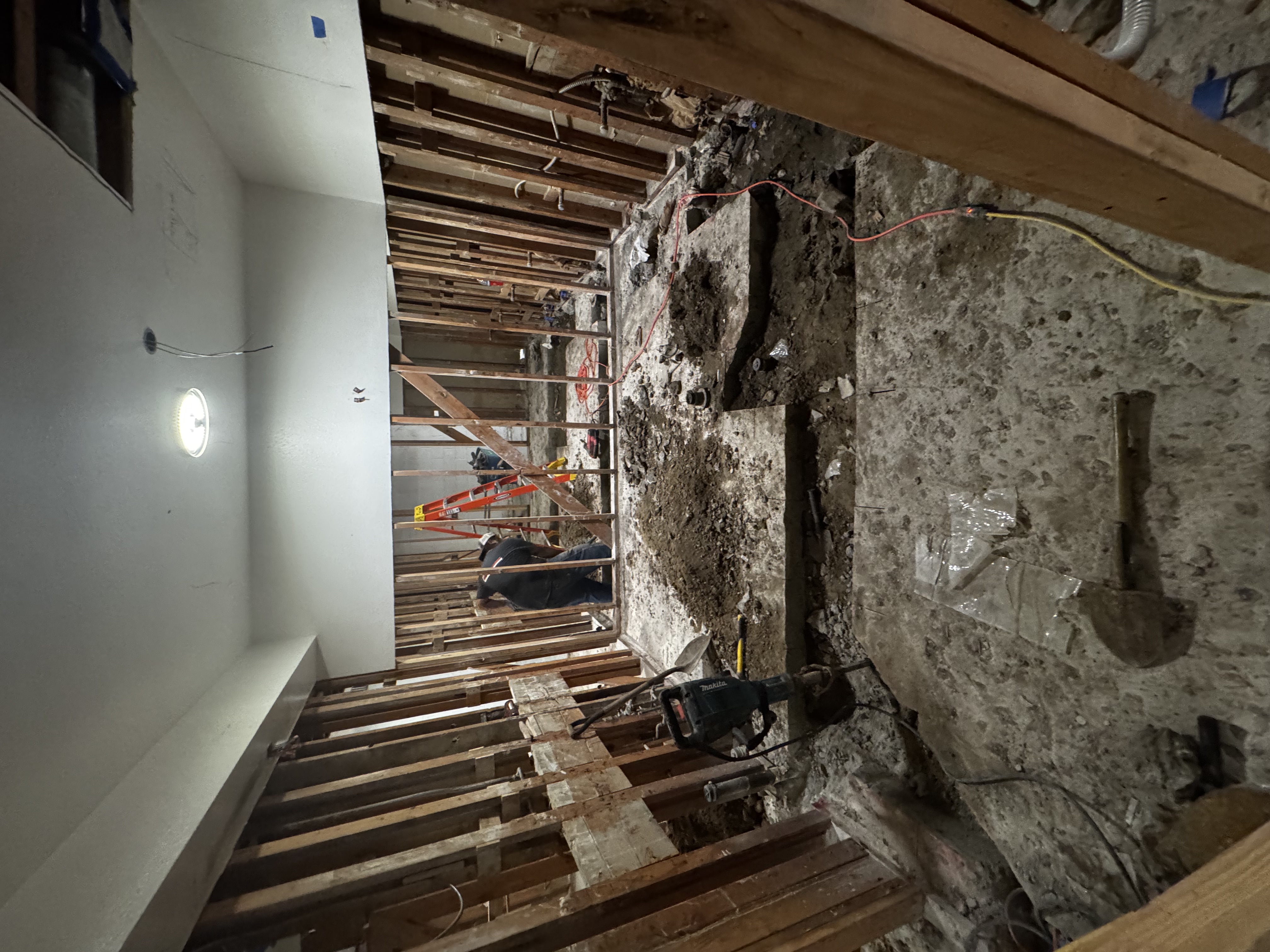

Remodel Began.
Status of Work
Chancel: COMPLETED AUGUST 31, 2025
2nd Floor Restrooms: COMPLETED OCTOBER 17, 2025
Youth Center Restrooms: COMPLETED OCTOBER 30, 2025
Youth Center Porch: COMPLETED DECEMBER 4, 2025
Sanctuary Ramp/Doors: COMPLETED NOVEMBER 29, 2025

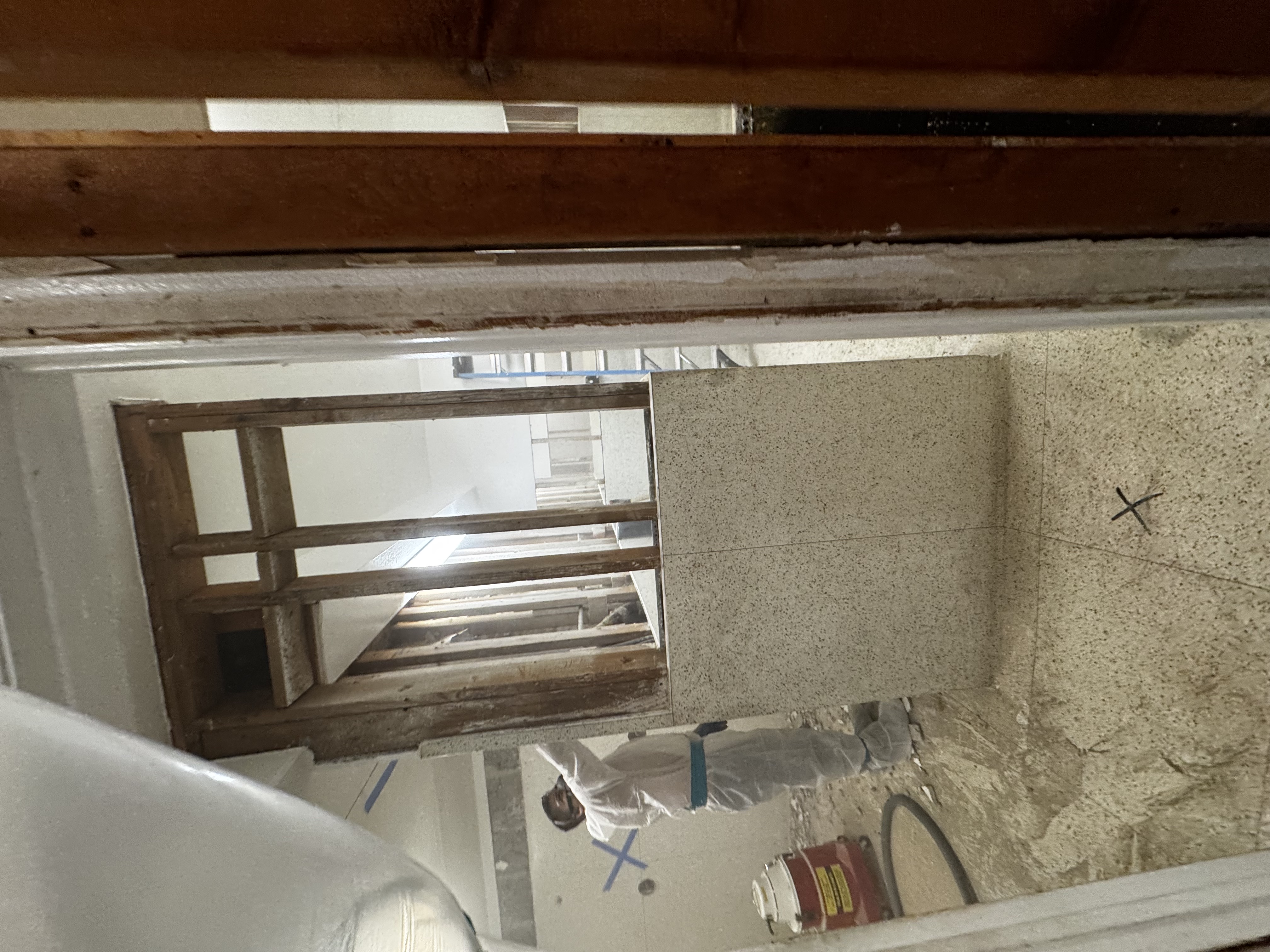

Gym Restrooms/Locker Rooms: Estimated Completion December 24

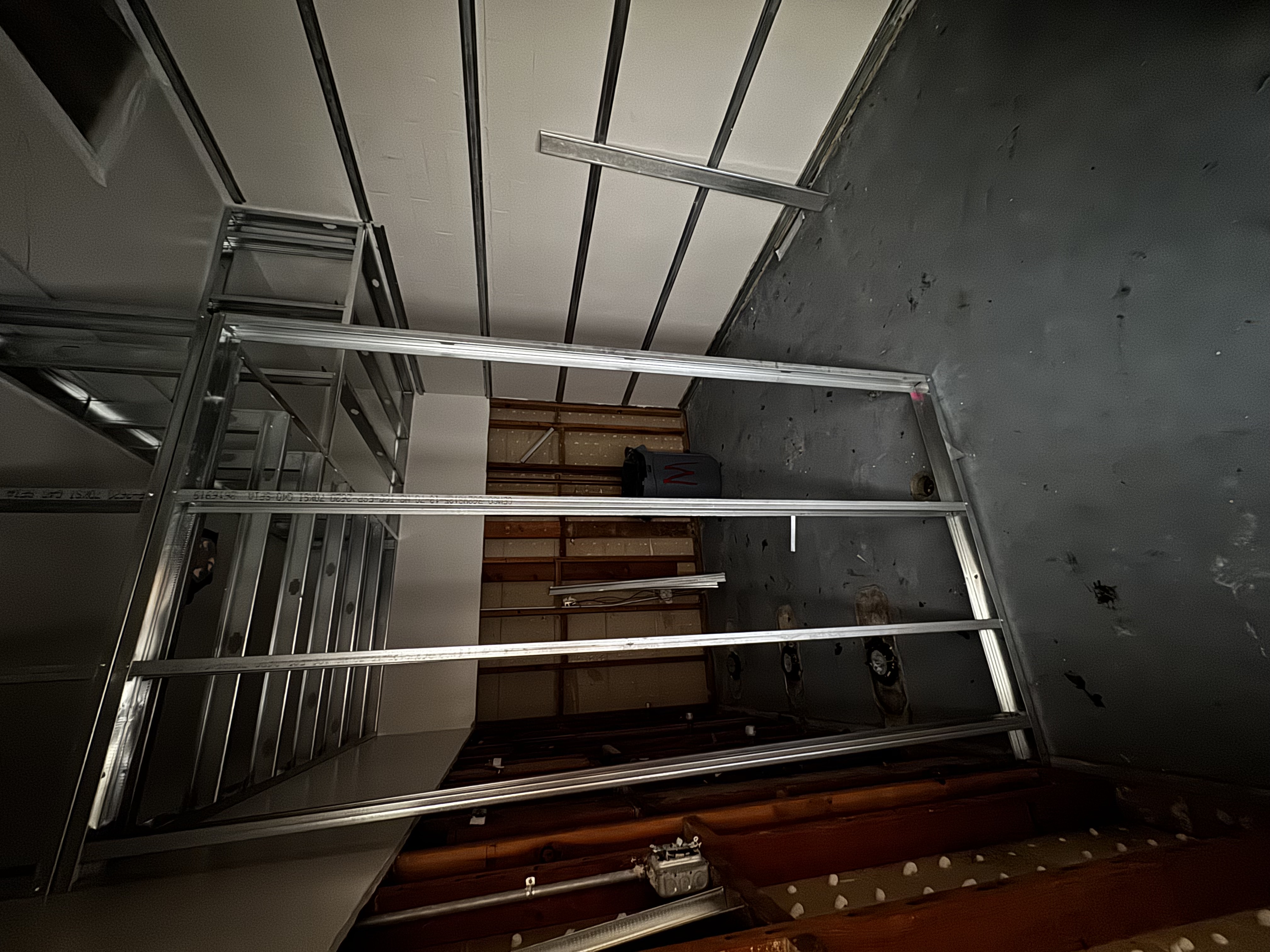

2nd Floor Accessibility: Estimated Completion January 30 (one ramp completed on November 29)

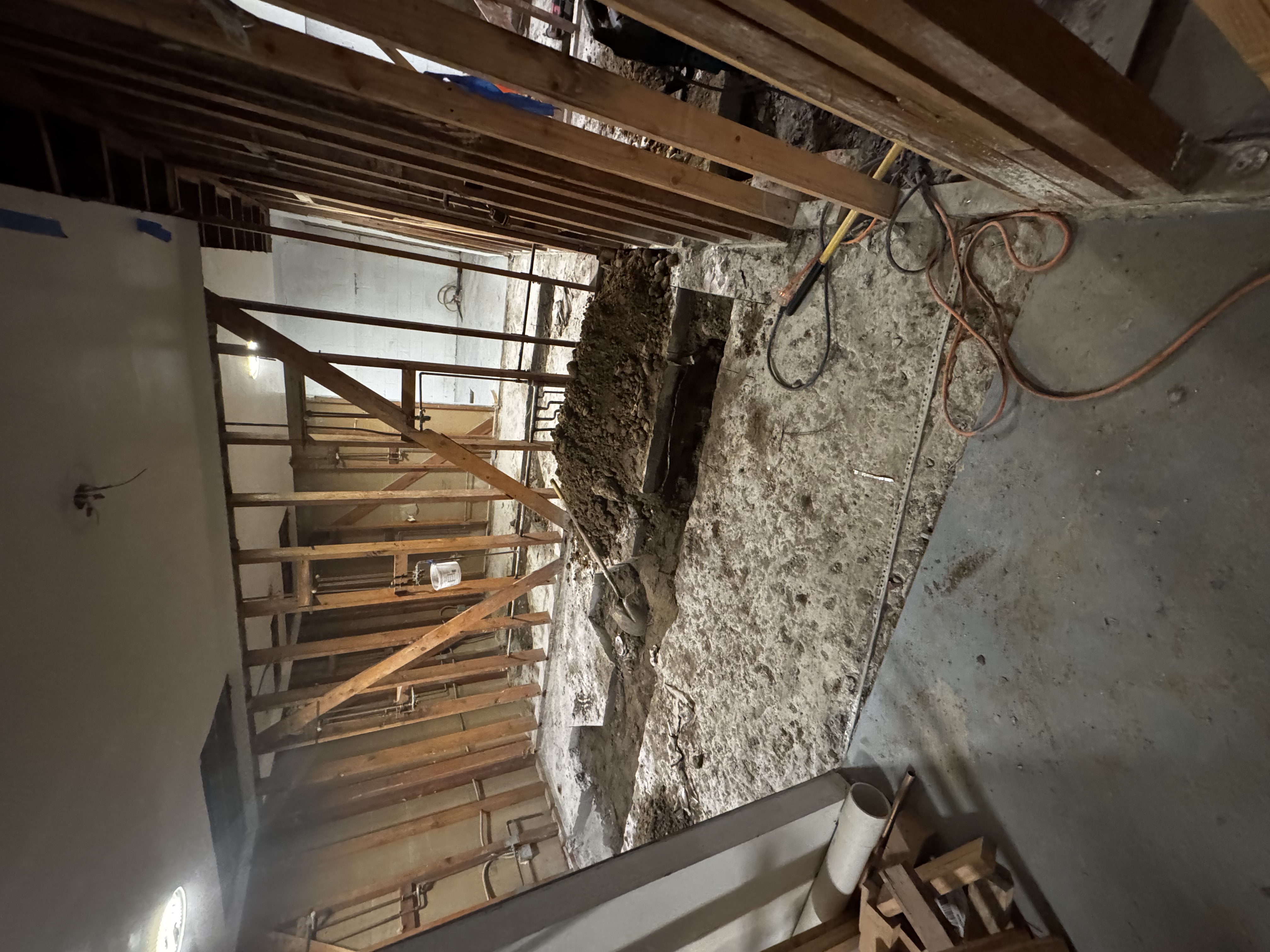

Youth Center Basement: Estimated Completion January 30
Office Restrooms: Pending

ADU: Pending
